When the National Hurricane Center places northeast Florida in a named storm's cone within 72 hours, responsible general contractors (GCs) do not wait for the last possible moment. They execute a documented site shutdown protocol while there is still time to do it properly — before the subcontractors clear out and the chaos begins.

At JK Prestige, this is not improvised. It's a written protocol that every superintendent executes in the same order, on the same timeline, documented on the same checklist. Here's what that protocol includes, what it protects against, and what it does not cover.

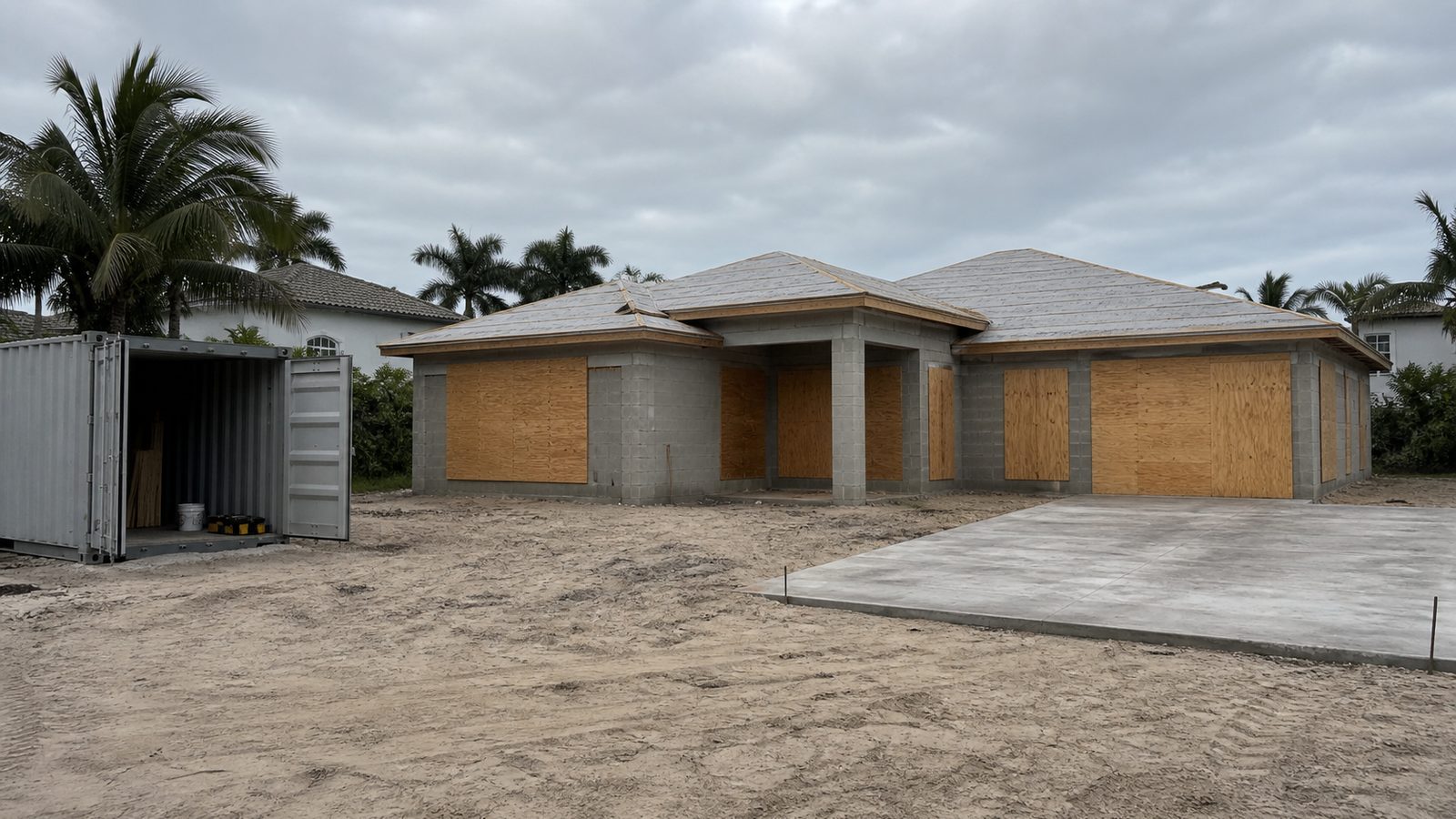

Boarded window and door openings at an unoccupied Florida masonry home under construction
Editorial illustrationPlywood-secured rough openings and a cleared work area show the coordinated shutdown that should be complete before storm conditions arrive.

Why the 72-Hour Window Matters

72 hours before projected landfall or severe impact: This is when the National Hurricane Center's track is reliable enough to make final go/no-go decisions on site shutdown, but early enough to execute the protocol without rushing. Waiting for 48 hours means material handling is compressed into a window when trades are also demobilizing and wind gusts are already beginning in outer bands.

48 hours before: All site work should be suspended. The site shutdown checklist should be complete. Any remaining securing work (additional tie-downs, final water extraction) should be finished before conditions make site access unsafe.

The economic pressure to keep working as long as possible is real. Owners and GCs both feel it — lost production days have direct cost. But the risk calculus flips completely when a construction site becomes a source of projectiles. Unsecured material on a construction site in a Category 1 or stronger hurricane is not a construction problem — it's a community safety problem.

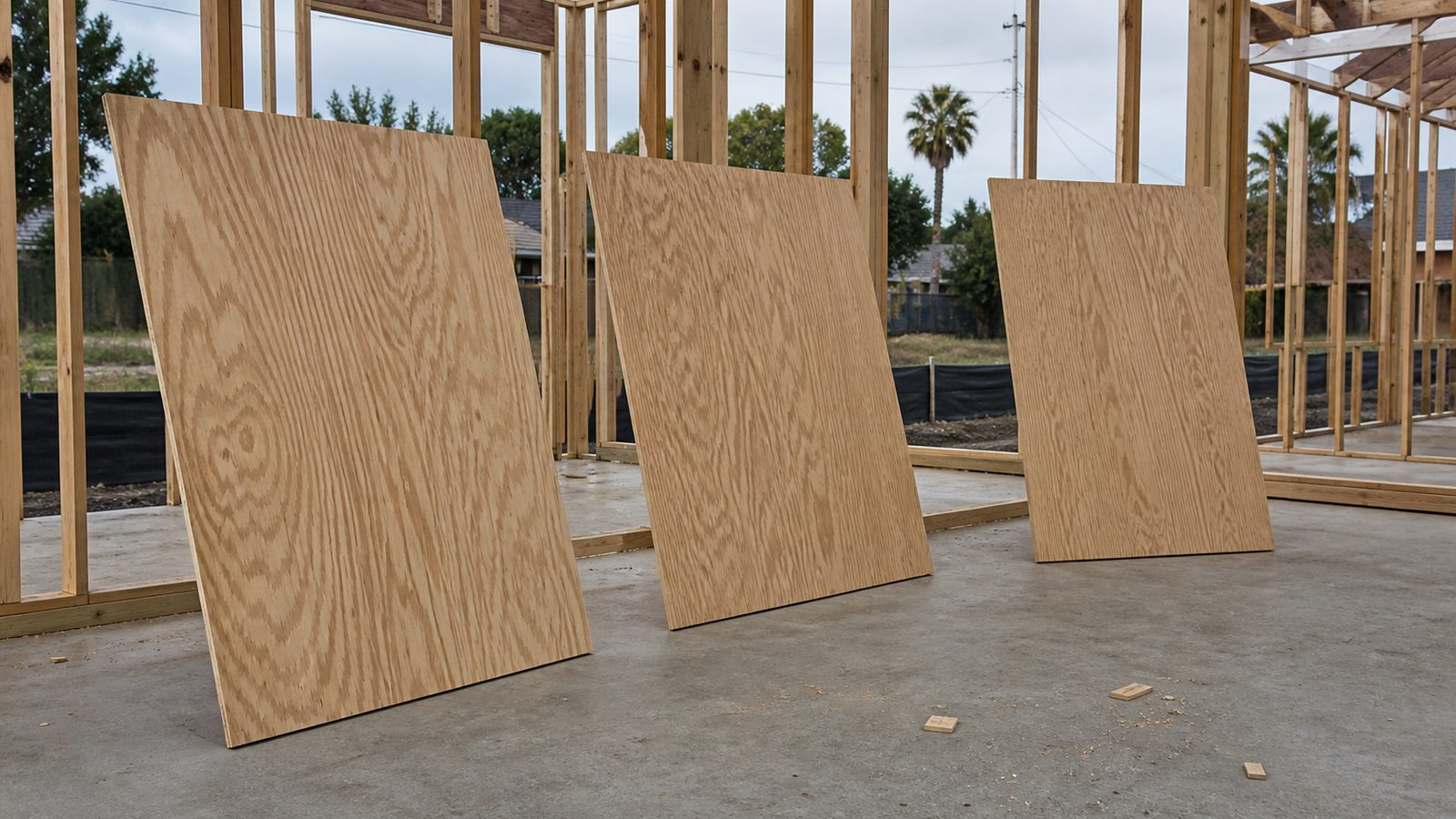

Three loose plywood sheets leaning inside an open Florida wood-framed construction site
Editorial illustrationUnsupported sheet material illustrates the projectile risk removed first when a construction site is secured for hurricane winds.

Step 1: Remove All Unsecured Material

The first priority is eliminating projectile risk. A construction site has an extraordinary density of lightweight, high-aerodynamic material — items that at 80 mph sustained wind become missiles.

What must be removed or secured:

Where it goes: Secured materials go into locked enclosed containers (dumpsters with lids, site trailers), into garages or enclosed structures if available on-site, or off-site entirely if the site has no enclosed storage. "On the ground with boards on top" is not sufficient in a hurricane wind event.

Step 2: Secure or Remove Scaffolding

Scaffolding is the highest-risk item on any construction site in a storm. An unsecured scaffold frame caught in 100 mph wind is a falling hazard and a projectile hazard simultaneously.

The options:

  1. Remove the scaffolding entirely. The safest option if there is time and equipment to disassemble before the storm.
  2. Dismantle to the lowest level possible and brace the remaining base section to the structure.
  3. Brace remaining scaffolding with diagonal knee braces and additional ties to the building structure at minimum 4-foot vertical intervals. OSHA and SSFI (Scaffold & Access Industry Association) provide guidance on scaffold wind bracing requirements.

There is no universally safe way to leave multi-story scaffolding standing through a hurricane. If the storm intensity is projected at Category 2 or greater, full removal is the only defensible approach.

Step 3: Pump Standing Water from Excavations

Any open excavation — foundation trenches, footings, utility trenches — will flood in a storm. A flooded excavation is not just a schedule problem; it's a structural problem.

What standing water in an excavation does:

Before the storm: pump all excavations to dry. Install sumps if pumping will take more than a few hours. Cover open excavations with plywood weighted down with sandbags or framing lumber to reduce the volume of water entering during the storm.

Step 4: Board Open Window and Door Rough Openings

A structure under construction with open rough openings is not a shelter — it's a wind tunnel. Open window and door openings create through-flow conditions that apply massive positive and negative pressure loads on partially framed walls. Framing that would survive a storm as part of a complete envelope may fail when wind flows through an unenclosed structure.

What to cover: All window rough openings, all door rough openings, and any other wall penetrations that have not yet received windows, doors, or permanent closure.

How to cover them: Plywood panels cut to fit the rough opening, secured with structural screws into the rough framing (not just staples). For openings in exterior sheathing, the plywood should overlap the sheathing on all sides to prevent wind infiltration at the edges.

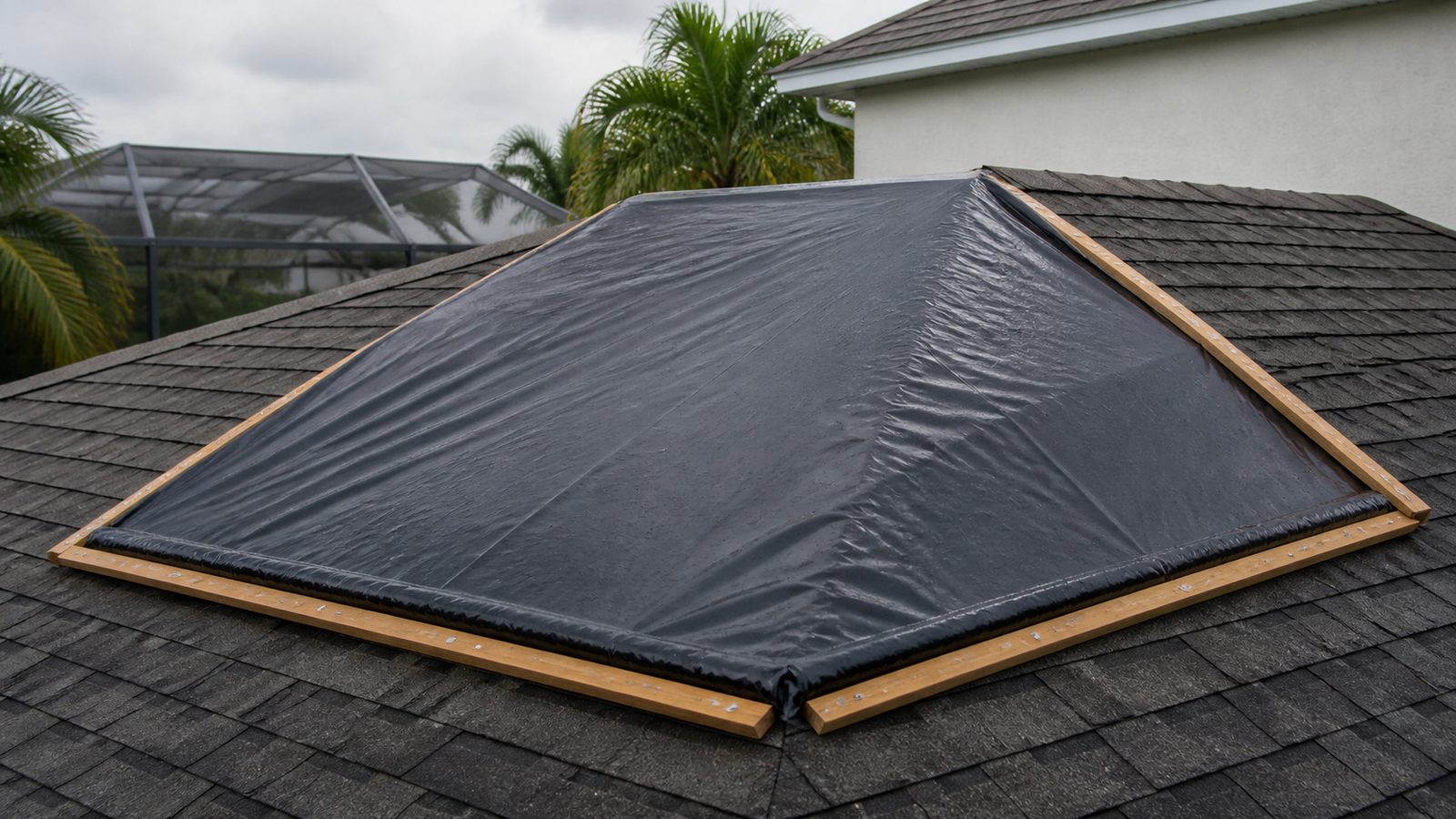

Dark roof sheeting secured across a Florida hip roof ridge with lumber battens around the perimeter
Editorial illustrationTemporary sheeting wrapped and fastened around perimeter battens shows how a partially exposed roof can be protected before severe weather.

Step 5: Secure Any Partially Installed Roofing

A partially installed roof is the highest structural vulnerability on a construction site. A roof with 40% of its shingles installed and 60% of its deck exposed will lose the installed shingles first — then the deck, and then the top plate.

What to do with a partially installed roof:

Step 6: Lock Containers and Site Trailers

Site trailers are wind-resistant but not hurricane-proof. Satellite trailers (the standard 8x40 or 10x40 site office trailers) should be locked and, if on wheels, should have their jacks lowered and wheel chocks in place. They should not be relied upon to survive a direct Category 2+ strike.

Electronic equipment (computers, tablets, survey equipment), project documents, and permit sets should be removed from trailers or secured in waterproof containers before the storm.

All material containers (CONEX boxes, enclosed dumpsters) should be locked and their positions documented so they can be confirmed after the storm.

Step 7: Notify Owner and Insurance

The GC's obligation: Notify the owner of the site shutdown, the expected timing, and the measures taken to protect the site and structure. This notification should be in writing — email with delivery confirmation.

What this notification includes:

What this notification does not do: It does not activate the owner's insurance or absolve the GC of responsibility for any damage caused by the GC's own operations or negligence. If the GC leaves equipment unsecured that becomes a projectile and damages a neighboring structure, that is a liability matter for the GC's general liability policy.

Builder's risk insurance: The owner is responsible for maintaining a builder's risk policy on construction projects. Builder's risk covers storm damage to the structure and materials during construction. The GC's general liability policy does not cover storm damage to the structure — that is the owner's builder's risk coverage. Confirming that the owner has an active builder's risk policy before hurricane season is a due diligence item that JK Prestige addresses at contract signing.

See how JK Prestige handles project communication and owner reporting at The JK Way and our general contracting expertise in Jacksonville.

Get a free written estimate in 48 hours. contact the JK Prestige team. For active projects with storm questions, call (904) 944-0278. A principal answers.

Get a written estimate in 48 hours.

No call center. No coordinator. A JK principal reviews every inquiry and replies with a real number, not a range, not a follow-up form.

Request Free Estimate →

Frequently Asked Questions

Why does JK start hurricane prep 72 hours before landfall instead of waiting?
The 72 hour mark is when the National Hurricane Center's track is reliable enough to make a final go or no-go decision on shutdown, while there is still time to execute the protocol without rushing. Waiting until 48 hours compresses material handling into a window when subcontractors are also demobilizing and outer band gusts may already be starting.
What has to happen to a construction site before a hurricane hits?
Every piece of unsecured material, loose lumber, insulation, roofing material, drywall sheets, and even paint cans, has to be removed or locked in enclosed containers, since any of it becomes a projectile at 80 mph. Scaffolding either gets fully removed or braced at minimum 4-foot intervals, open excavations get pumped dry, and open window and door rough openings get boarded with plywood secured into the framing, not just staples.
What happens to a partially installed roof if a hurricane hits mid-project?
A roof with some shingles installed and much of the deck still exposed is the highest structural vulnerability on a site, because the installed shingles fail first, then the deck, then the top plate. Installed sections get additional fastening where time allows, and unsheathed or un-shingled sections get covered with temporary modified bitumen or heavy poly tarp secured directly into the deck.
